This is not an opinion, it is a fact.
Some time back I put in an FOI request following revelations stemming from another concerning the Environment Agencies monitoring of this hazardous waste site post “remediation” , which of course is not in any way complete given that the site permit is still in force.
The main focus of this was reference to a report which Rhodia and their consultants ERM had delayed sending to the EA as required as part of the remodelled permit regulations concerning monitoring data.

I will look at the supplied information in due course which in itself is mind blowing. In particular it is extraordinary and rather difficult to believe that a consultancy, and a laboratory between them could somehow lose samples that had been taken- damning ones at that I would suggest making the prospect of deliberate sabotage of results a very likely possibility. But here the internal review by the EA to their delayed response, apologies over poor understanding of the FOI process and information which is in the public interest to disclose is a work in itself.

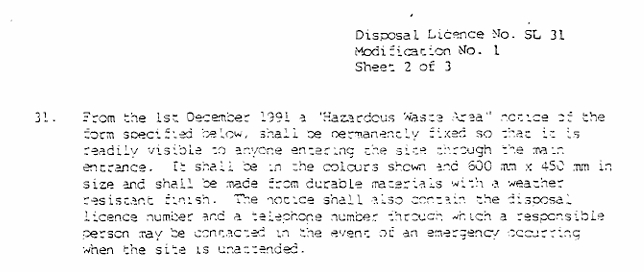

To be fair to the EA, their previous responses to requests I have made via WDTK have demonstrated them to be one of the better authorities in responses and disclosure. But even back in the day, I was told by Dave Whitford, former Environment management that people were asking questions within the EA (who?) as to whether they should be answering my questions! This I found and still do find very troubling, particularly in the era of the likes of Richard Parker and his attempts to overrule and bully the authority into granting planning permission for housing on shit contaminated land like Friar Park, as well as the agencies steer into burying the waste licences that were issued in the 1970’s and diluting the dangerous chemicals that were buried. Why do some unnamed people in the civil service not want the public to know information? Is anyone paying them to hide it? Erasing public records and reclassifying what you call something I have looked at HERE.
THIS, BY DODGY MEANS, IS A COVER UP FOR A FEW TO MAKE FINANCIAL GAIN, AND ANYONE INVOLVED IN THIS DECEIPT OR THE EASING OF ITS PASSAGE HAS THEIR PERSONAL INTEGRITY TO BE QUESTIONED, INCLUDING TOP POLITICIANS AND OFFICERS WITHIN THE EA.
This is why I would recommend anyone asks FOI/EIR requests through whatdotheyknow.com, as there is a clear trail of the request and a timeline. There is also public domain publication which cannot be hidden or gatekept by a biased legacy media. The timeline of this request factually is as follows.

8/4/2026 I make a request to the EA via WDTK.
9/4/2026 EA issue an acknowledgement response.
29/5/2026 Over one month after the request I had not heard anything from the EA so sent in a request for an internal review.
4/6/2026 Response from EA stating that they will carry out a review by 28/7/2026
29/7/2026 Date they had set themselves, response again from EA giving a strangely worded response about their legal team, and wanting to ensure a full response. (At this point I thought they were trying to concoct an exemption excuse for not releasing the report).
9/9/2026 Now some 5 MONTHS after making the request I send a chaser asking for a final date.
18/9/2026 EA finally respond with information requested.
25/9/2026 EA issue the internal review which is shown below.
There is a preamble which basically describes the events as already outlined above.

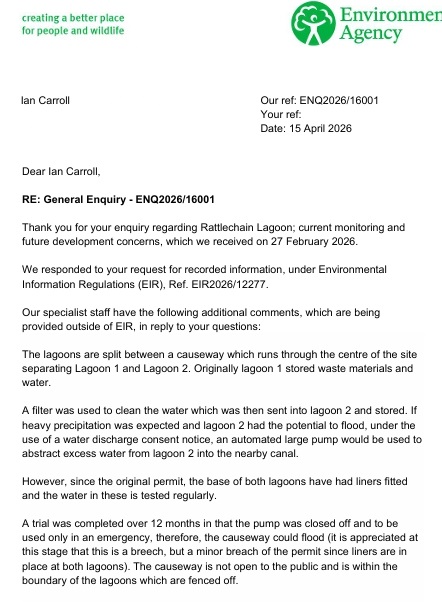

The substance of the response and explanation for the five month delay is given as follows.
“I recognise that the time taken to respond to your request was unacceptable and
sincerely apologise for the delay and any inconvenience this may have caused.
My review found that the delay was caused by a combination of avoidable factors,
including confusion between similar information requests, uncertainty between teams
regarding responsibility for responding to the enquiry, and a lack of understanding
around public register information, intellectual rights, and commercial confidentiality
considerations. These issues led to unnecessary discussions and additional checks
that significantly extended the time taken to provide the information. In particular, an
initial delay occurred when the enquiry was not actively progressed after being
received, and subsequent concerns about the ownership and disclosure of
monitoring reports. This resulted in consultation with the permit holder that, while
undertaken in good faith, was not required and contributed further to the delay.
We have identified a number of lessons learned and improvement actions to help
prevent similar delays in future. My review found no evidence that any member of
staff deliberately sought to delay or withhold information; rather, the delay arose from
misunderstandings, uncertainty and process inefficiencies that should have been
managed more effectively.”
- The EA apologise for the delay being “unacceptable”, it was given that I had been explicitly clear as to which report I was referring to, which was named.
- The EA say this was caused by “avoidable factors”, I would say entirely on their own staff failing to properly respond to the request.
- I would say that if they do not understand public register information, should they be on the job? Or what does this say about the transparency of the EA really, in context with how I believe they have been tasked or steered by the political class to not disclose information?
- The report was not commercially confidential, but someone in the EA appears to have inserted that excuse for attempted delay.
- This appears to have led to discussions with Rhodia! SINCE WHEN HAVE THEY BEEN THE GATEKEEPERS OF WHAT THE PUBLIC SHOULD KNOW WHEN THEY HAVE REPEATEDLY COVERED UP INFORMATION, LIED AND BEEN DISENGENUOUS THROUGHOUT THEIR ENTIRE OWNERSHIP OF THIS HAZARDOUS WASTE SITE!
- “LESSONS LEARNED” ETC.
OTHER CONCERNS ABOUT THE EA AND ITS MONITORING AND DISCLOSURE

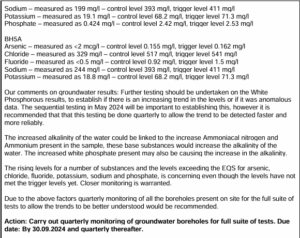

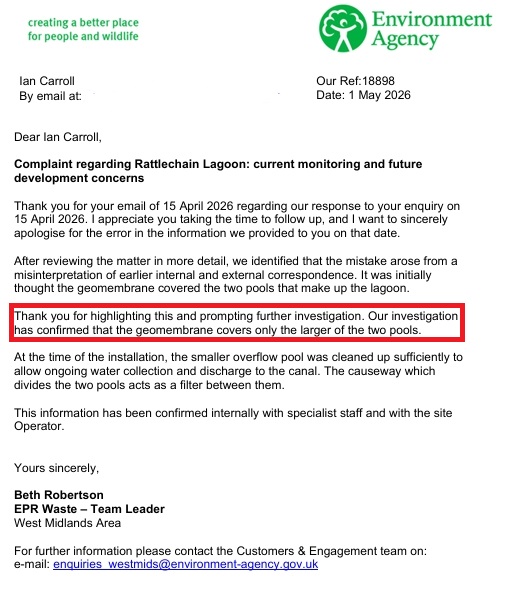

In a previous correspondence with the EA, I was given clear misinformation about the remediation status of this site where they admitted
“I appreciate you taking the time to follow up, and I want to sincerely
apologise for the error in the information we provided to you on that date.”.

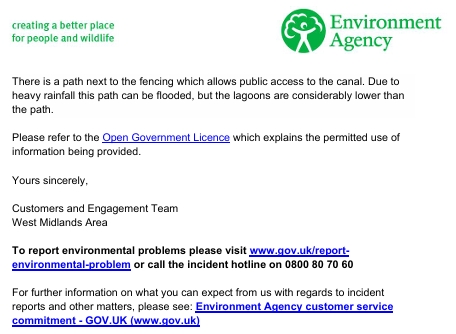

The correspondence continued
allow ongoing water collection and discharge to the canal. The causeway which
divides the two pools acts as a filter between them.
Operator.“

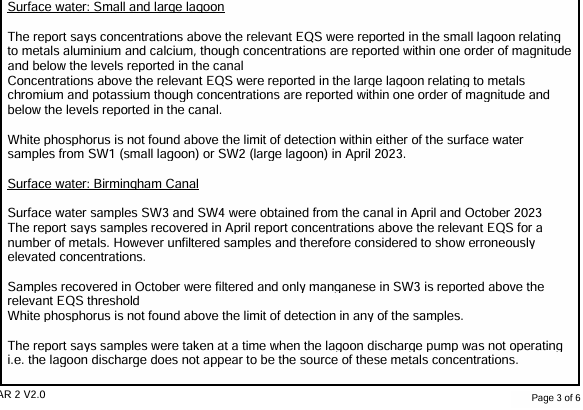

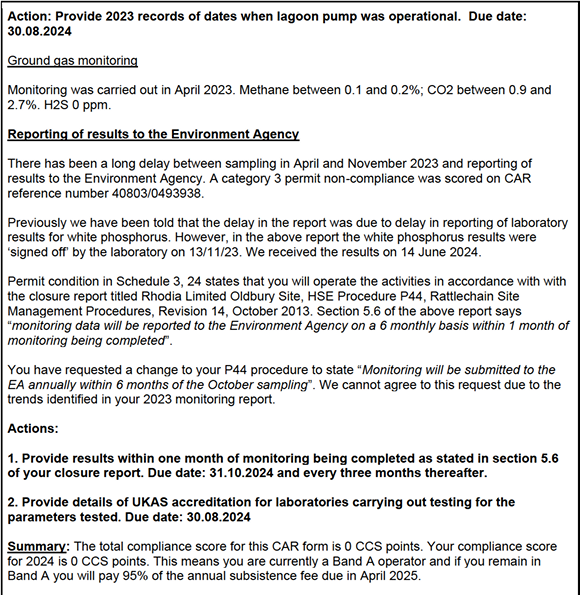

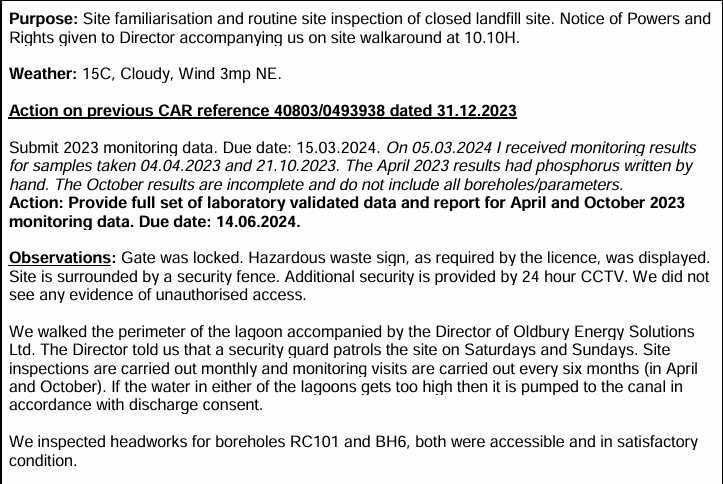

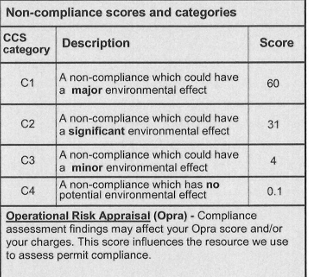

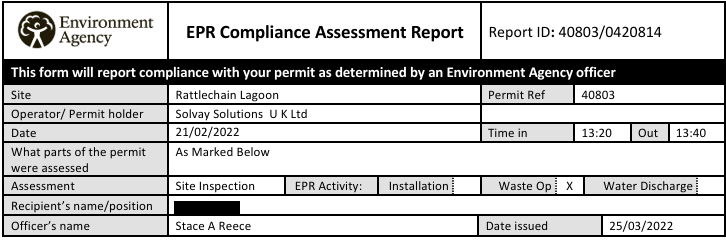

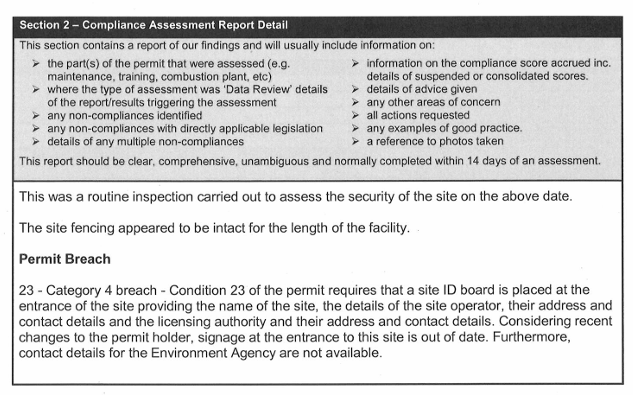

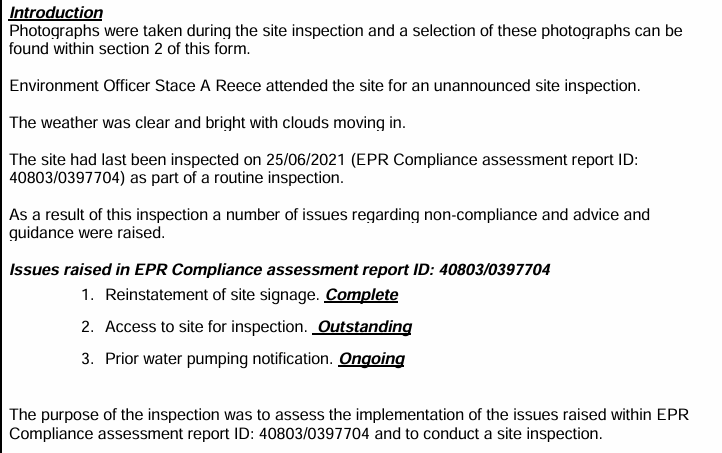

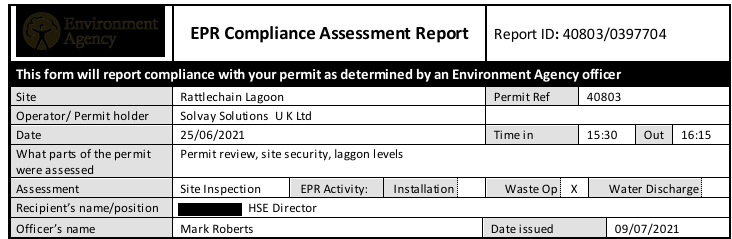

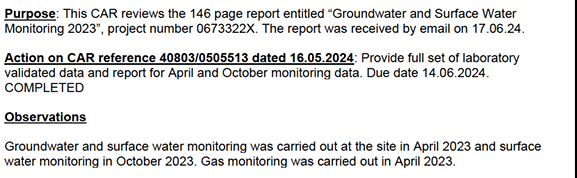

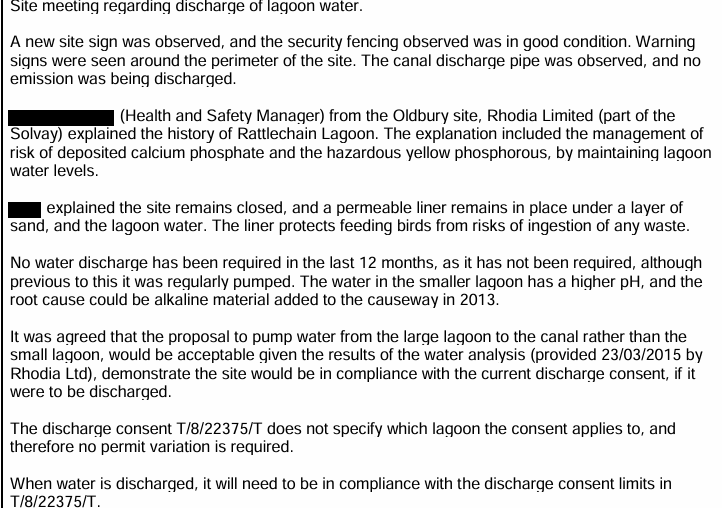

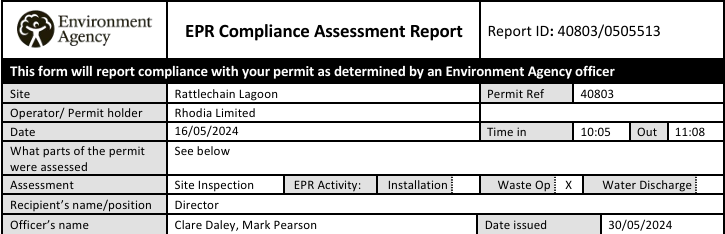

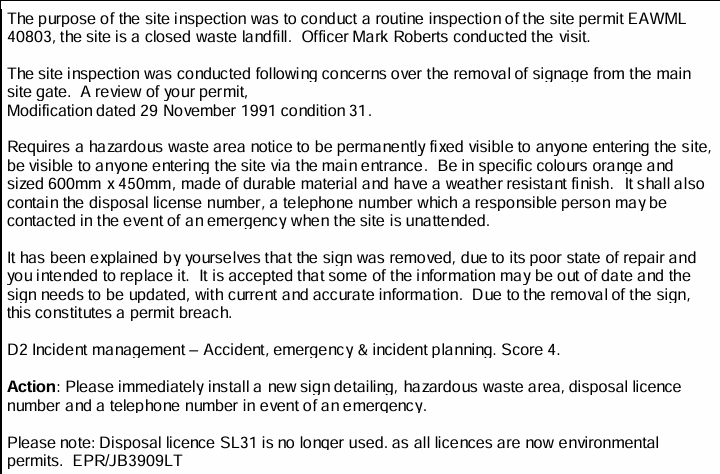

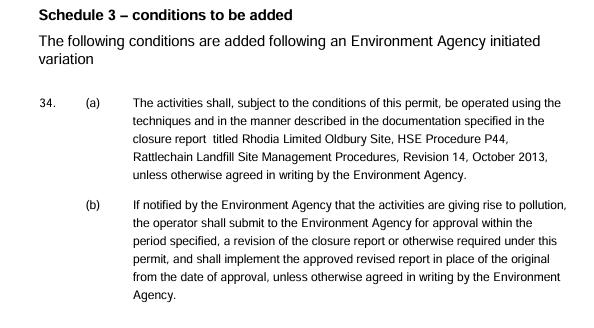

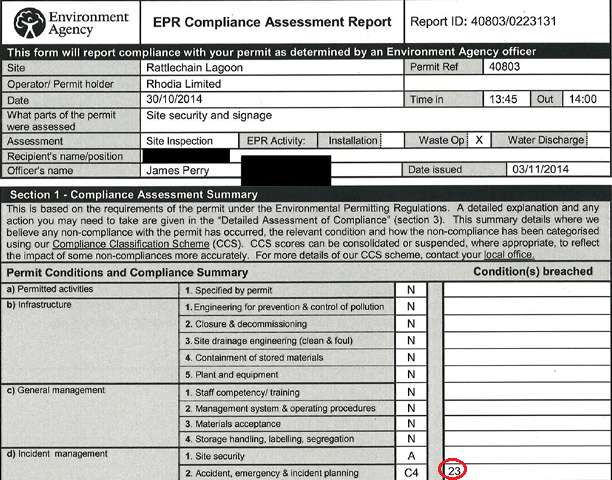

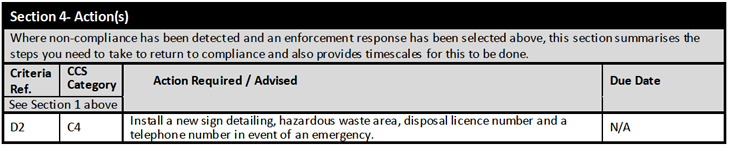

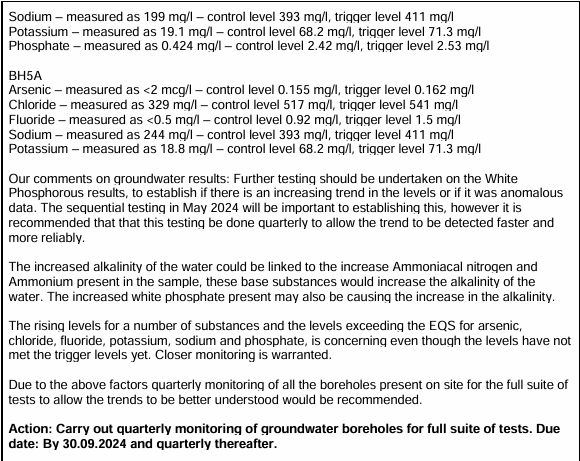

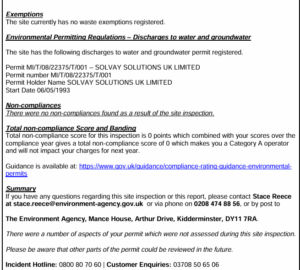

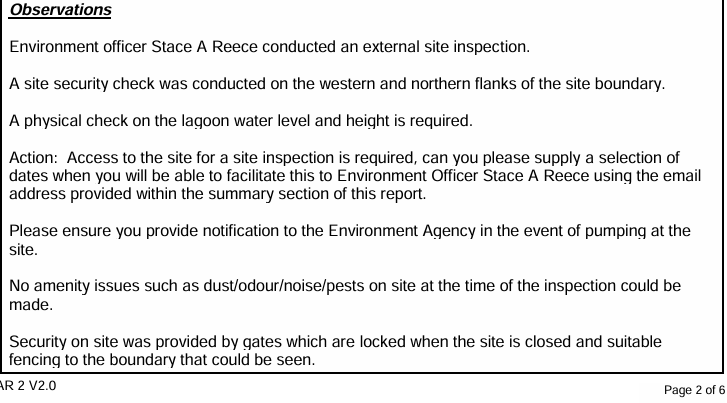

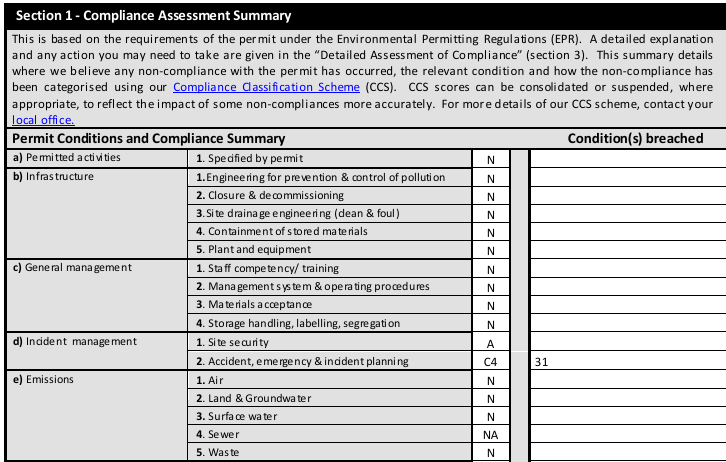

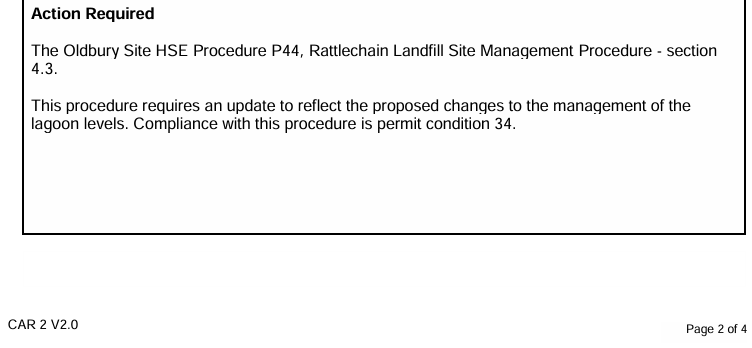

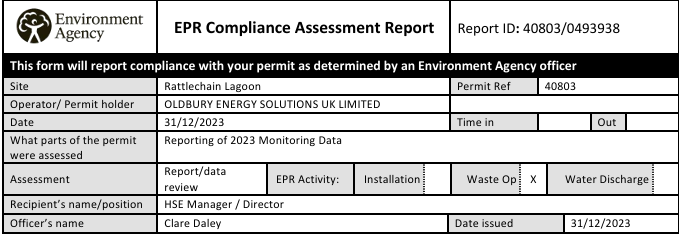

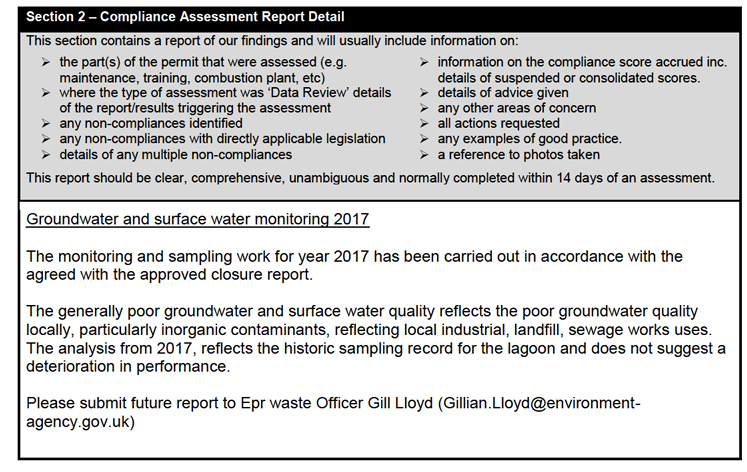

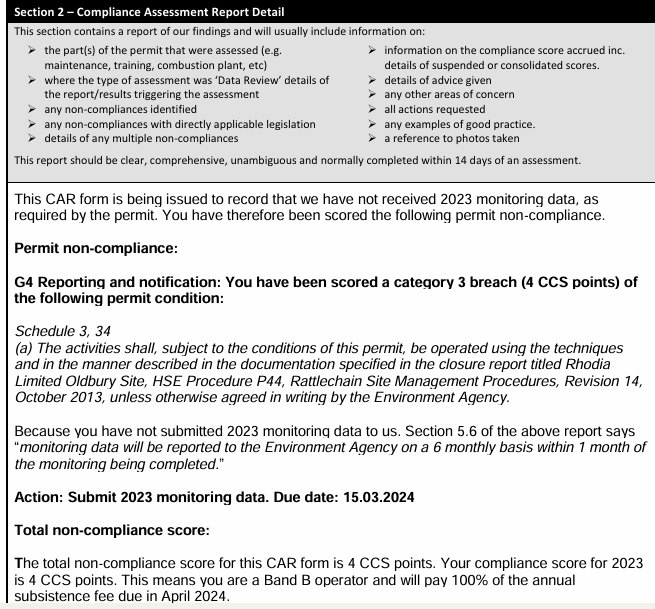

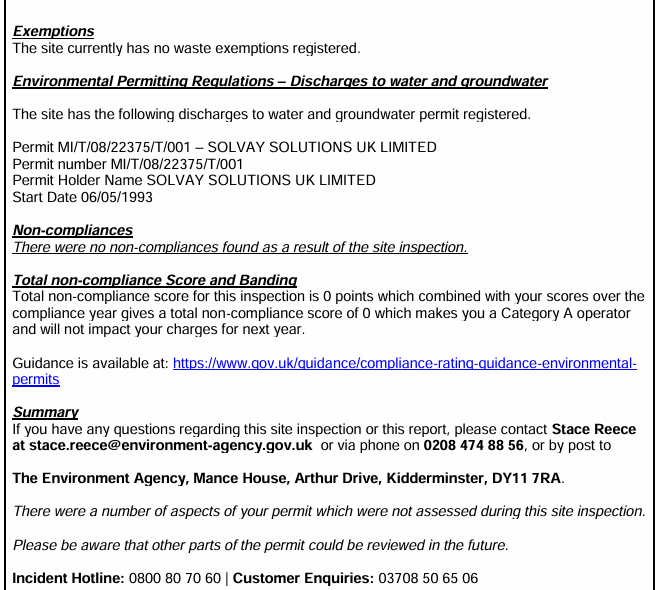

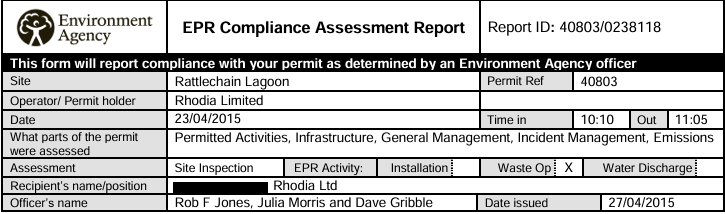

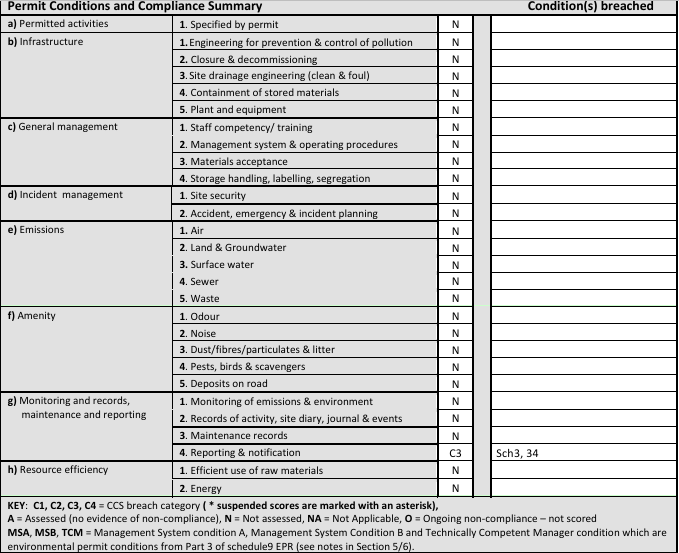

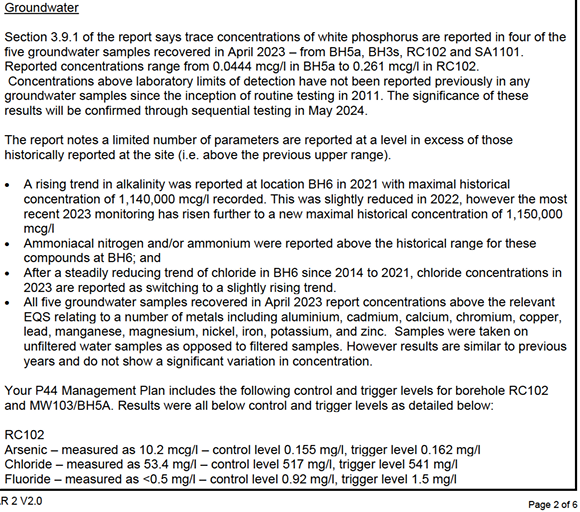

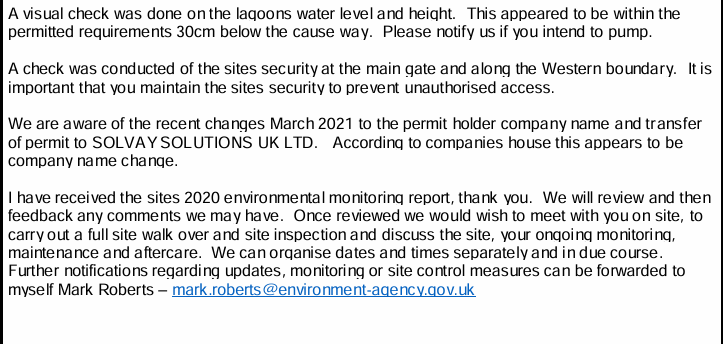

Not only is the EA’s historic knowledge of this site just not credible on this matter, but as I have looked at following their FOI compliance assessment reports, the frequency and standard is not up to scratch and they are missing in action. To repeat the statistics in that post

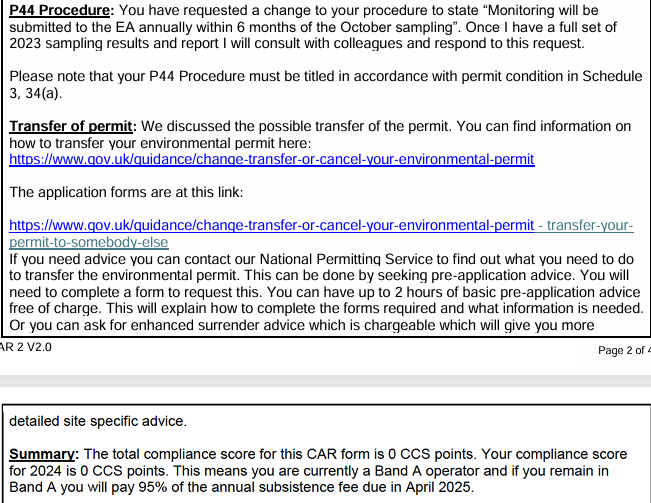

Subsequent clarification by the EA has only provided just 9 reports in 12 years up to 2025.
This compares to 182 inspection response forms, of which 71 recorded a breach of the permit waste management licence between 1996-2006.
NOTE TO EA, IF YOU WANT TO KNOW ANYTHING ABOUT RATTLECHAIN LAGOON, YOU KNOW WHERE TO FIND ME!
